Integra Gold Commences Development of Underground Exploration Ramp at Lamaque-South Gold Project, Awards Promec Mining Inc. with Contract

Integra Gold Corp. (TSX-V: ICG; OTCQX: ICGQF), is pleased to announce that it has awarded Promec Mining Inc. with the contract to construct the Triangle Deposit exploration ramp on the Lamaque-South Gold Project (“Lamaque”) in Val-d’Or, Québec. Promec has mobilized all required equipment on site and hired more than 90% of its team. The first rock blast for the exploration ramp took place earlier this week.

Press Release Highlights:

  • Creation of more than 65 new jobs for the Val-d’Or region
  • Ramp will expedite close-spaced and exploration drilling along with bulk sampling of gold mineralized material to reconcile against the resource estimate
  • Extensive surface exploration campaign to continue alongside underground exploration

VANCOUVER, BC: Integra Gold Corp. (TSX-V: ICG; OTCQX: ICGQF), (“Integra” or the “Company”) is pleased to announce that it has awarded Promec Mining Inc. (“Promec” or “Promec Mining”) with the contract to construct the Triangle Deposit (“Triangle”) exploration ramp on the Lamaque-South Gold Project (“Lamaque”) in Val-d’Or, Québec. Promec has mobilized all required equipment on site and hired more than 90% of its team. The first rock blast for the exploration ramp took place earlier this week.

Val-d’Or, Québec based Promec Mining was selected following a detailed bid evaluation process conducted by the Company. Promec specializes in contract underground mining, development, construction and operations. Promec has worked on numerous projects throughout Eastern Canada, including contracts with Agnico-Eagle, Hecla, Glencore, and others.

Langis St-Pierre, Integra’s Chief Operating Officer remarked, “By awarding this contract to Promec Mining, an experienced Val-d’Or based mining contractor with a long history of successful contract mining in the Abitibi, our Lamaque project enters an exciting and important new phase of its evolution. The transition to underground exploration at Triangle is an important milestone for Integra’s technical team and the Company’s shareholders. We have been looking forward to the first rock blast of the ramp construction as it represents the culmination of five years of focussed exploration at Triangle. Our decision to construct this exploration ramp also reflects the Company’s on-going commitment to the community of Val-d’Or through job creation and the economic stimulus generated by the project.”

Jos Deschenes, Promec Mining’s General Director commented, “Promec Mining is extremely proud to be part of the initiation of this new project in the Val-d’Or area. We are excited to work with a dynamic company like Integra Gold, whose hard work and dedication have made this project possible. In collaboration with the Integra team we will make this project a success and one that will continue the proud mining tradition of Val-d’Or and the Abitibi-Temiscamingue region.”

Exploration Ramp Objective, Details and Plans

The exploration ramp construction specifications are designed to be 5.1 metres (“m”) in width and 5.0 m in height and will include 420 m of lateral development in mineralized zones contained in C1 and C2 zones. The exploration ramp development will reach an estimated vertical depth of 180 m and Promec is projecting the ramp will advance at a rate of 175 m per month. Promec will be utilizing Integra’s facilities built at the Triangle site for equipment maintenance and, if required, its own facilities located 3 km from the portal allowing for timely maintenance and repairs to equipment with minimal downtime.

The objective of the underground exploration program is to conduct close-spaced drilling from within the upper portions of the Triangle deposit (C1 and C2 zones) as well as exploration drilling in order to continue growing the resource base. The proposed underground exploration program will also include a bulk sample of more than 20,000 tonnes of gold mineralized rock required for the purposes of reconciling gold content versus resource estimates as well as to allow for detailed metallurgical test work to be conducted. The ultimate size, location and timing of the bulk sample will be determined using information gathered from the results of the ongoing surface exploration drilling and from underground drilling as results become available.

To view a 3D plan of the ramp, please click on the link below:

https://vimeo.com/176342989/b1348ffc54

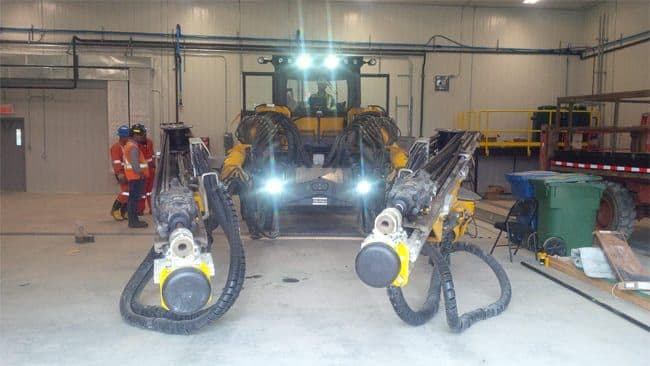

To view recent photos of the portal, jumbo drill and bolter, please click on the link below:

http://www.integragold.com/s/triangle.asp?ReportID=757223

Budget and Timeline

The budget for the underground exploration ramp is approximately C$26 million with work estimated to take between 12 months and 15 months. The contract with Promec includes the provision of an experienced underground work force and a modern mining fleet while Integra will supply the required construction materials. Having recently hired 65 skilled miners to complete the task, Promec will work in conjunction with Integra’s technical team throughout ramp construction. The Company is fully funded to see this work through to completion and all necessary permits are currently in place.

Surface Infrastructure Installed in 2015 to Help Expedite Timeline

The surface infrastructure and ramp collar required for the exploration ramp was completed in the fall of 2015 at a cost of C$5.6 million. As a result of this work surface infrastructure already in place includes site management offices, maintenance facilities, site services (25 kv powerline, industrial and dewatering mine water lines, potable and waste water lines, etc). In addition, a new road from the Triangle site to the Sigma Mill was built which will allow for more efficient transportation of mineralized material and personnel in the future.

Project and Company Profile

Integra Gold is a junior gold exploration company advancing projects in Val-d’Or, Québec, one of the top mining jurisdictions in the world. The Company’s primary focus is its high-grade Lamaque South project. In 2014, Integra completed the accretive acquisition of the Sigma Mill and Mine Complex, a fully permitted 2,200 ton per day mill and tailings facility. With major federal and provincial permits in place, existing infrastructure and exploration potential, this acquisition removed major costs and shortened timelines typically associated with mine projects. With a current market capitalization of approximately $300 million, Integra has raised over $100 million since 2013, at successively higher share prices, despite depressed gold prices. In August 2015, Eldorado Gold Corporation completed a strategic investment in Integra, acquiring 15% of the outstanding common shares. Integra was recently named to the TSX Venture top 50 performers in 2015 and the OTCQX Best 50 award for 2015.

Qualified Person

The Lamaque project is under the direct supervision Francois Chabot, Eng., Operations and Engineering Manager of the Company. Mr. Chabot is a Qualified Person (“QP”) as defined by the National Instrument 43-101. The Company’s QP has reviewed the scientific and technical content of this release.

ON BEHALF OF THE BOARD OF DIRECTORS

Stephen de Jong
CEO & President

CONTACT INFORMATION

Corporate Inquiries:
Chris Gordon: chris@integragold.com
Or visit the company website: www.integragold.com

Follow Integra Gold On:
• Twitter: http://twitter.com/integragoldcorp

Neither the TSX Venture Exchange nor its Regulation Services Provider (as that term is defined in the policies of the TSX Venture Exchange) accepts responsibility for the adequacy or accuracy of this news release.

Cautionary Note Regarding Forward-Looking Statements: Certain disclosures in this release constitute forward-looking statements, including timing of completion of an updated resource estimate, timing of completion of an updated PEA and completion of the Sigma-Lamaque transaction. In making the forward-looking statements in this release, the Company has applied certain factors and assumptions that are based on the Company’s current beliefs as well as assumptions made by and information currently available to the Company, including that the Company is able to obtain any government or other regulatory approvals, that the Company is able to procure personnel, equipment and supplies required for its exploration and development activities in sufficient quantities and on a timely basis and that actual results are consistent with management’s expectations. Although the Company considers these assumptions to be reasonable based on information currently available to it, they may prove to be incorrect, and the forward-looking statements in this release are subject to numerous risks, uncertainties and other factors that may cause future results to differ materially from those expressed or implied in such forward-looking statements. Such risk factors include, among others, those matters identified in its continuous disclosure filings, including its most recently filed MD&A. Readers are cautioned not to place undue reliance on forward-looking statements. The Company does not intend, and expressly disclaims any intention or obligation to, update or revise any forward-looking statements whether as a result of new information, future events or otherwise, except as required by law.
